Ahh... walls! Rock Concrete was back in again this morning to strip the forms and reveal our walls. With the calcium added to the concrete under OBC rules, the concrete has cured very fast.
Tuesday, November 29, 2016
Monday, November 28, 2016
Friday, November 25, 2016
Ready to pour
The guys finished their forming work and rebar this morning, but the crappy weather means we are shifting the pour until Monday.
Thursday, November 24, 2016
Working in the rain
The walls were pretty much complete today and now we wait for a good window to pour. Tomorrow looks like a mixed bag forecast, so it may be pushed to Monday.
Wednesday, November 23, 2016
Forming begins
The guys from Rock arrived mid day after finishing their last house, and started preparatory work for the forming that they hope to complete tomorrow.
Tuesday, November 22, 2016
Monday, November 21, 2016
Footings repinned
GTA Surveying was in today to repin the wall locations while we stripped out all of the wood and garbage away from concrete footings.
Friday, November 18, 2016
Finally, we pour
Well, after an unsettling week of responding to phantom issues raised by an unknown neighbour [by the way, I've never understood people who call the City/Province/Parking/Police for the seemingly sole purpose of delaying the project and costing the owner of the house, their neighbour, more money...but I digress...], Rock Concrete was finally able to come in and pour the footings. Yeah!
Friday, November 11, 2016
Footings
Phil was in today with his team of 5 to form and level the footings. These guys are one of the most specialized trades in the business, and they are in high demand by both custom home builders and large multi-unit developers to do their thing!
Thursday, November 10, 2016
The other hole!
Everybody wants a walkout these days... whether it's for potential future rentals or just an excuse to rake more leaves...
Walkouts can be challenging, especially in an area like Etobicoke that has variably high water table levels depending where you are digging. Due to the fact that the walkout has to be dug four feet below the basement floor level, it can be quite deep, which poses not only water risks but also risks of collapse during excavation. This is why I always fill the excavated part of the walkout with concrete. It provides the most stable surface to build the walkout and exterior adjoining wall on, and also speeds the process of forming the walls (otherwise they have to form a wall, pour it, wait, come back, strip footings, waterproof then do it all again.
Here was the first of 3 9-meter full concrete trucks to deposit their load in the giant walkout at 150 Van Dusen...
Wednesday, November 9, 2016
Tuesday, November 8, 2016
Survey
The first time we need the surveyor in is to locate "the cut". The surveyor will put stakes at various areas (usually a meter outside each corner of the house) and provide us with a measurement denoting how deep to cut the excavation.
Monday, November 7, 2016
Friday, November 4, 2016
Wednesday, November 2, 2016
Demo before demo...

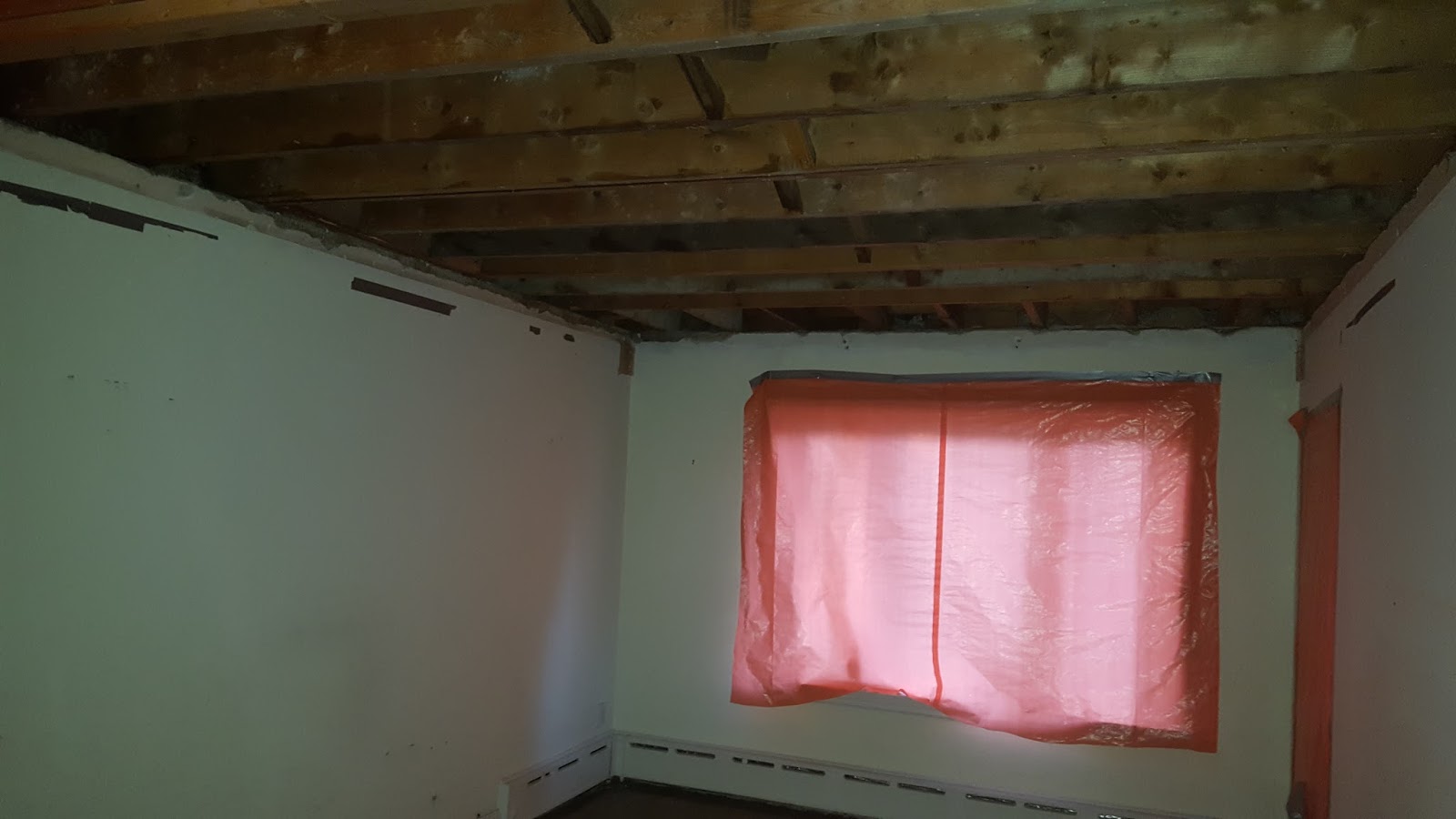

DSR (Designated Substance Report) tests came back positive, though in an ever-so-small way, so we had to get some ceiling and flooring out using a special remediation crew.
They did a great job, responding on time and throwing a big crew at the job so it wouldn't set our actual demolition back too much. Thanks to Frank Dodaro at Coast to Coast Environmental Inc!
They did a great job, responding on time and throwing a big crew at the job so it wouldn't set our actual demolition back too much. Thanks to Frank Dodaro at Coast to Coast Environmental Inc!
Tuesday, November 1, 2016
Testing the house before demo
The lab tech was in today to test for hazardous materials. Unfortunately, he found trace amounts of asbestos in the ceiling and some other areas, so we're going to have to get that removed before taking out the rest of the house. They should be done by Thursday, so not too bad, but it is a wasted expense.
George and the machine have to wait until Friday...
